|
A Guide to Implementing the Theory of
Constraints (TOC) |
|||||
|
Multi-Project Drums |
|
|
|
A Shorter Critical Chain On the
previous page we noted that any task that can be made parallel, rather than
serial, should be moved, and more importantly any task that can be taken from
the critical chain and put into a feeding should also be moved. On that basis

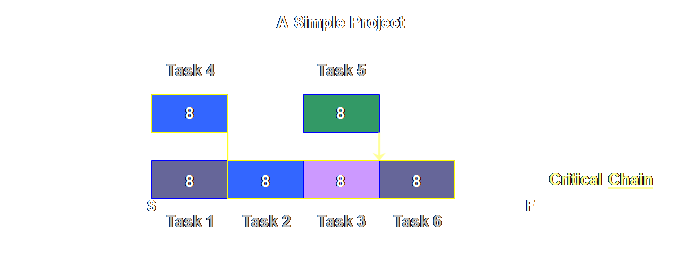

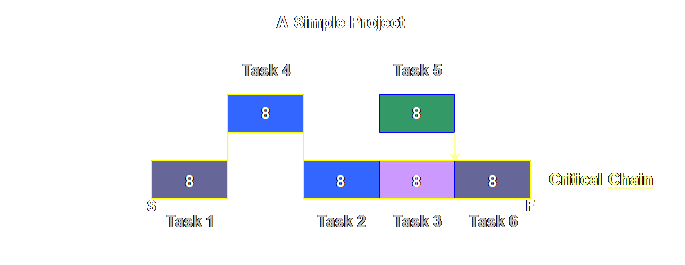

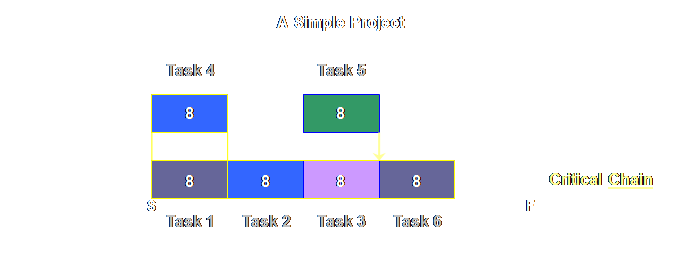

our simple plan has one task that could and should be moved. Here is the plan as it stands.
Let’s have a look.

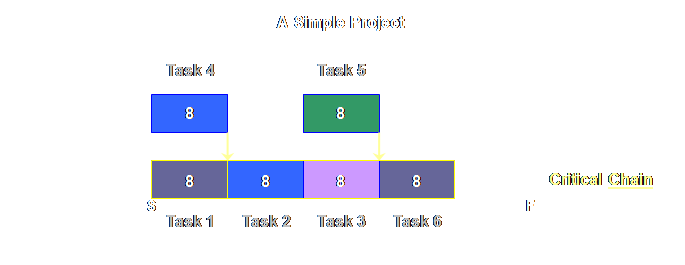

Both choices are valid! Which one to choose? If there is a choice it would make more sense to
keep task 4 and 2, both manned by the blue resource, on the critical

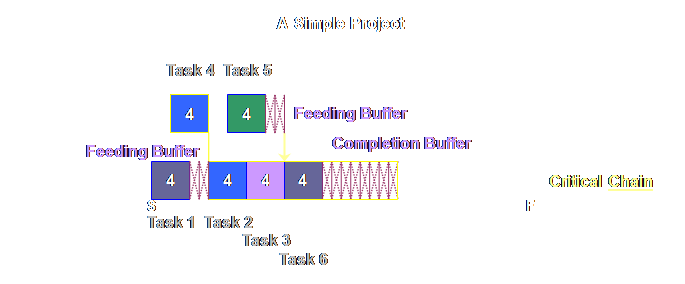

chain. Here is how the final buffered
project would look.
This is a nice little illustration of some of the
things that can happen with critical chain, don’t lose sight of the overall
objective. This Webpage Copyright © 2008 - 2009 by Dr K. J.
Youngman |
